CULVERCROFT DIARY

Building Culvercroft II (click on pickies below for more info)

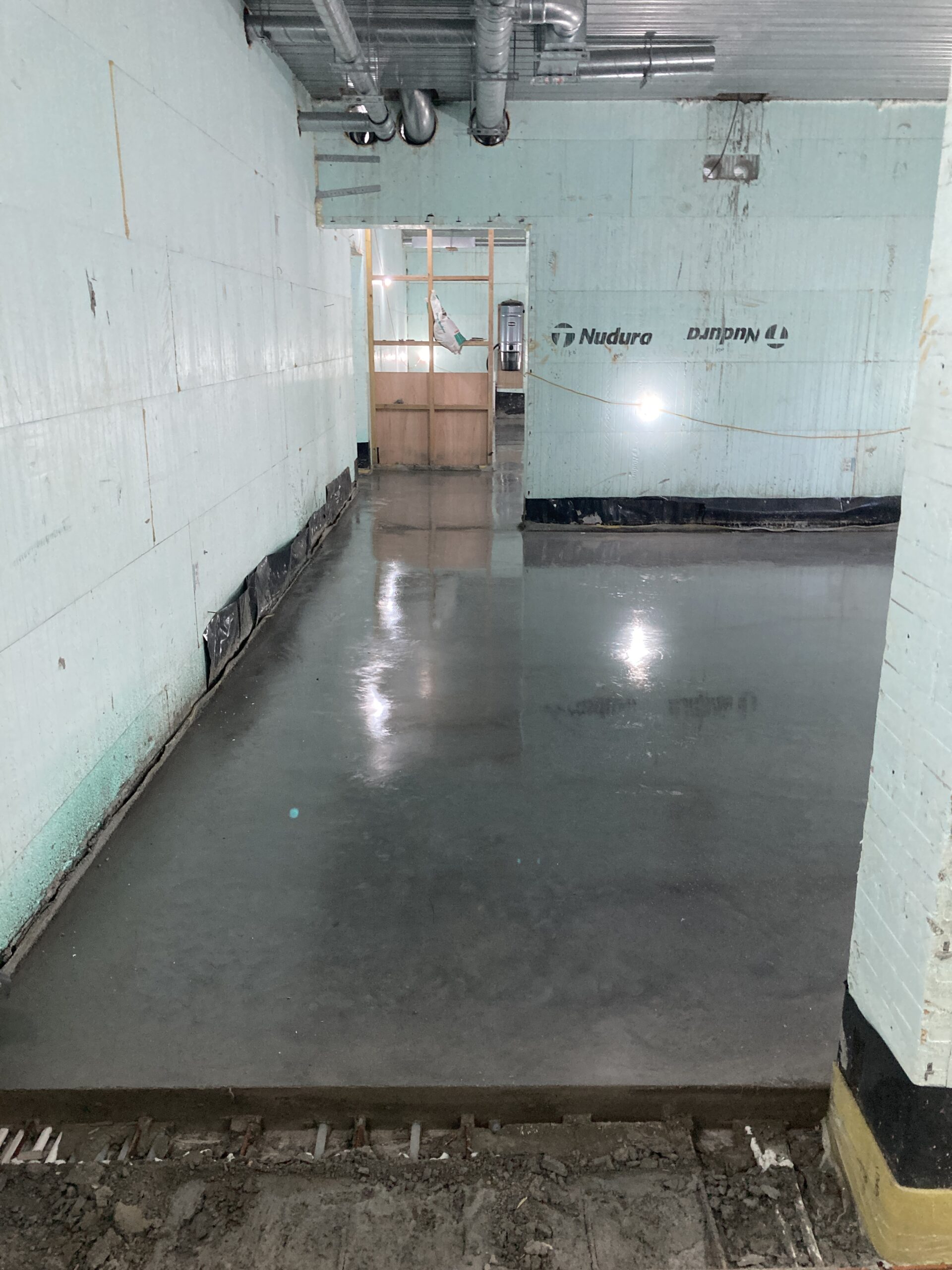

October 2024 – downstairs floor and starting studwork upstairs

October 2024 – downstairs floor and starting studwork upstairs

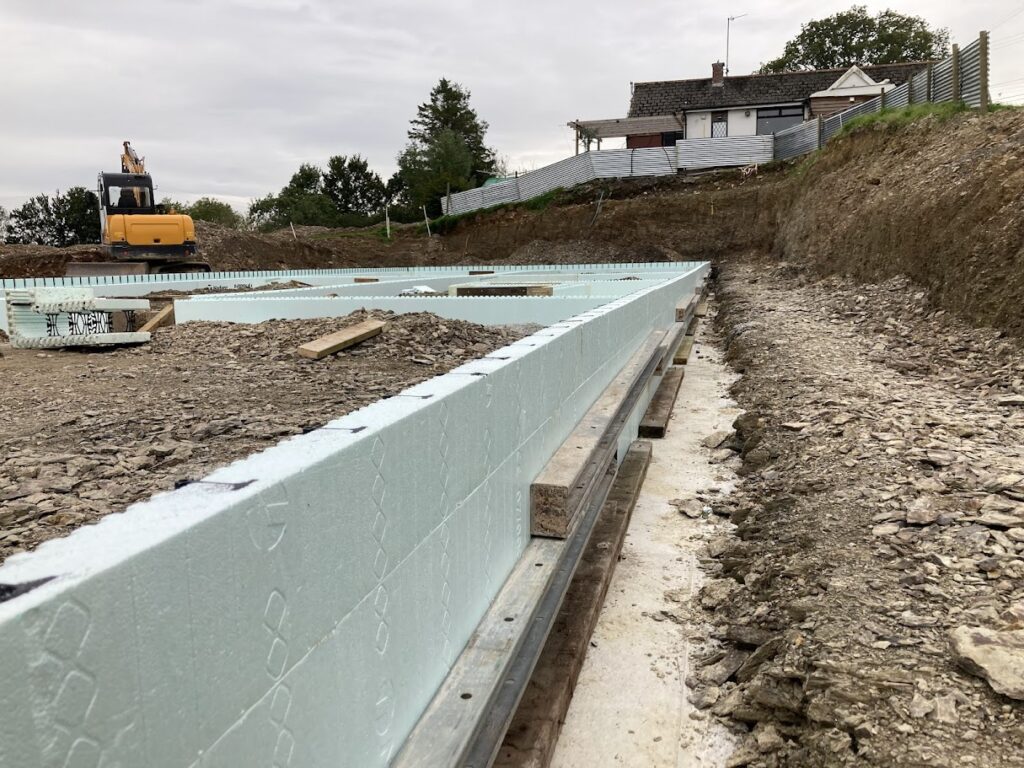

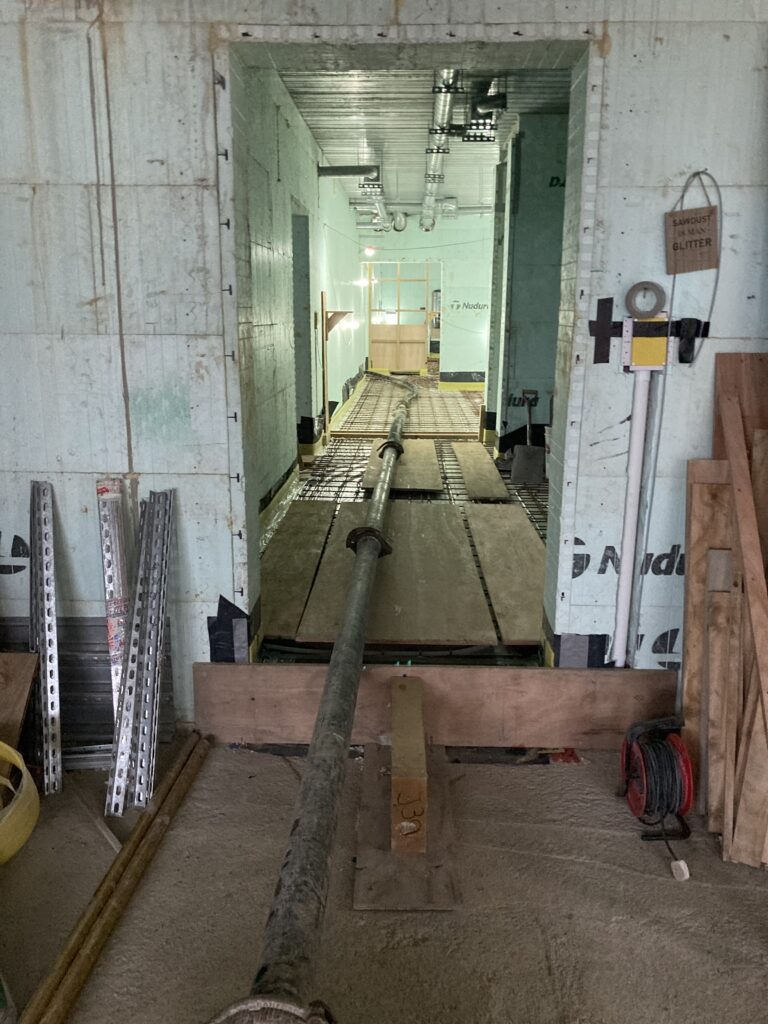

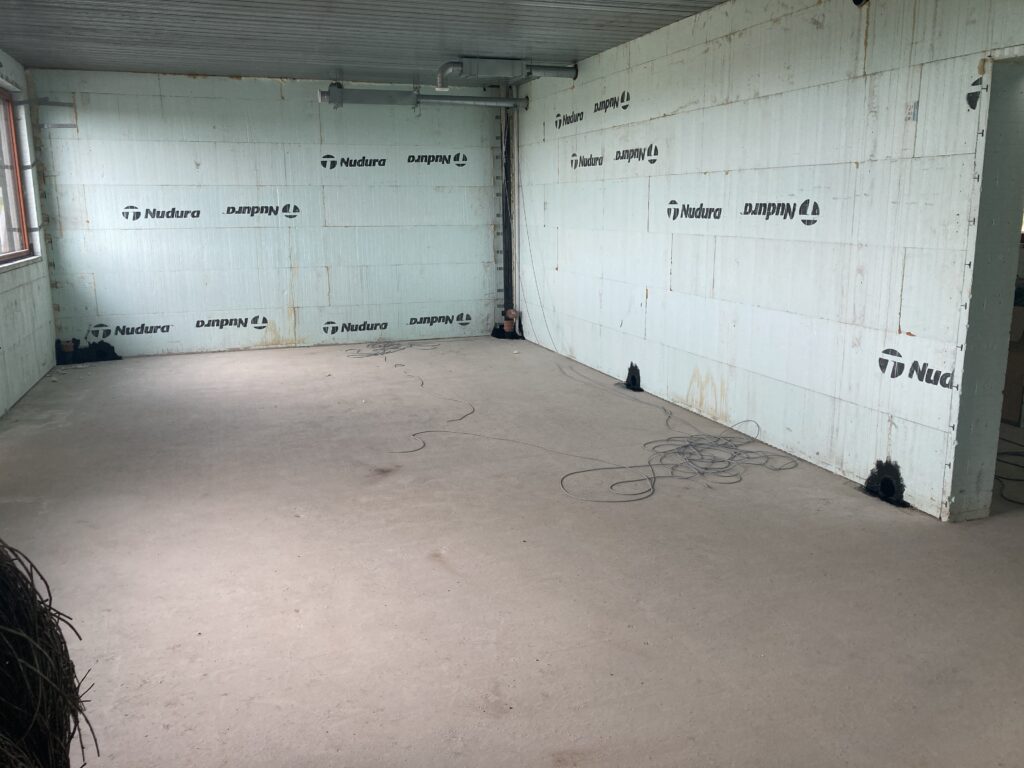

First we had to get the dpm in and seal around openings with bitumen as well as dpm. Then the vacuum pipework before the insulation…

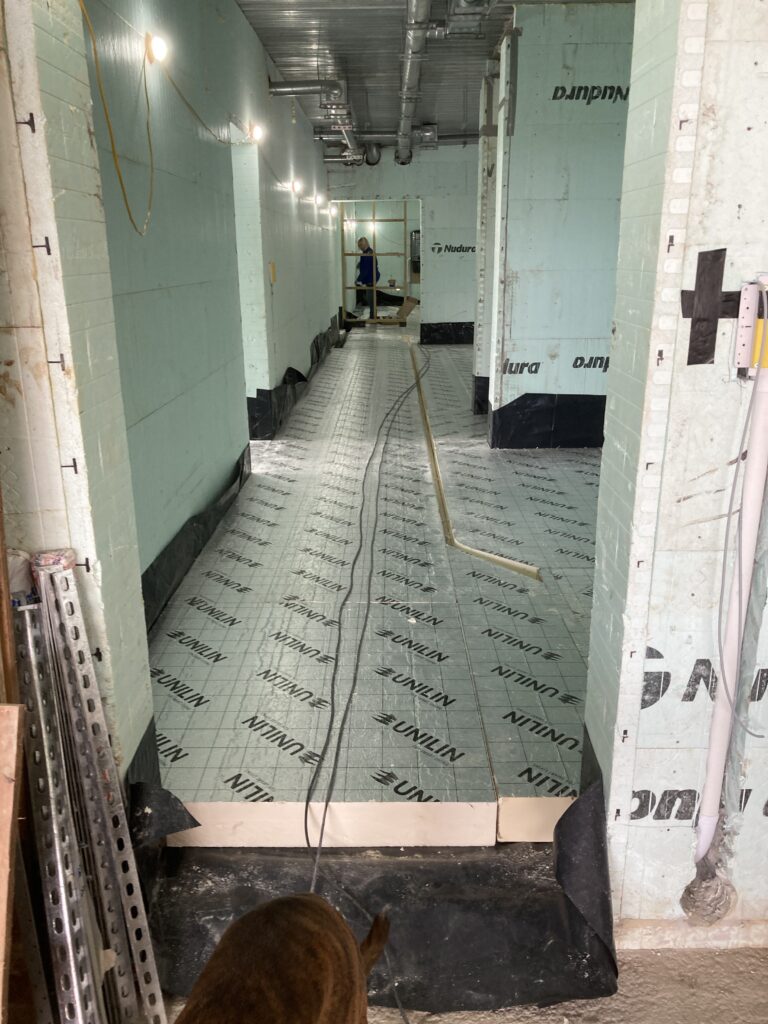

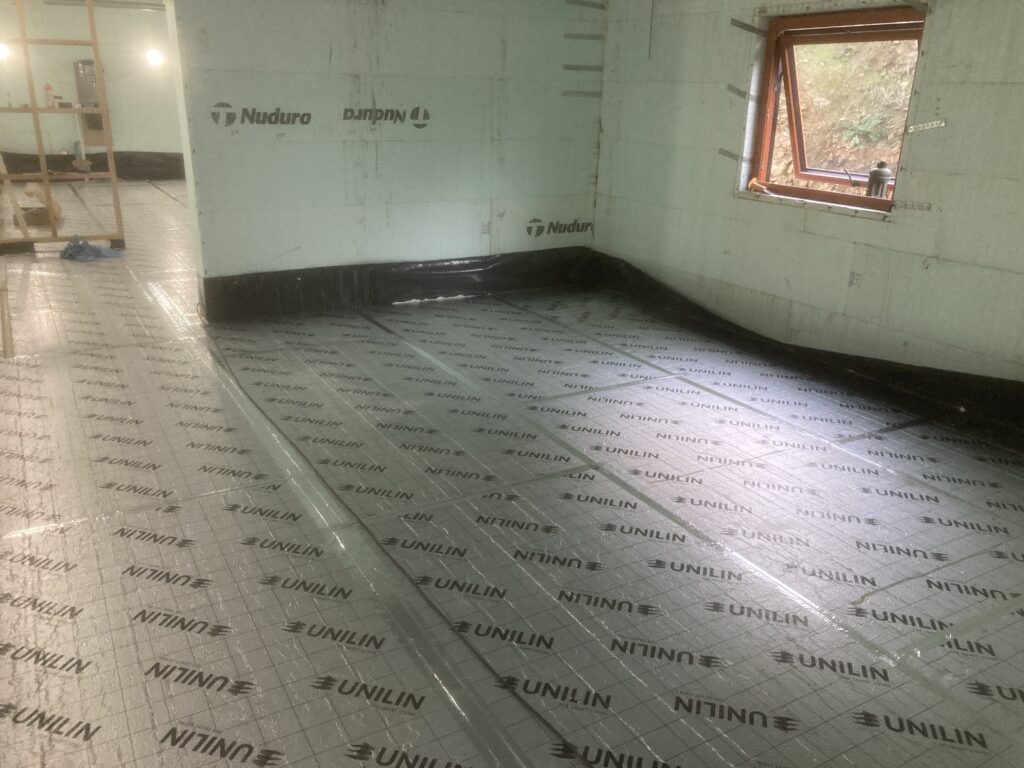

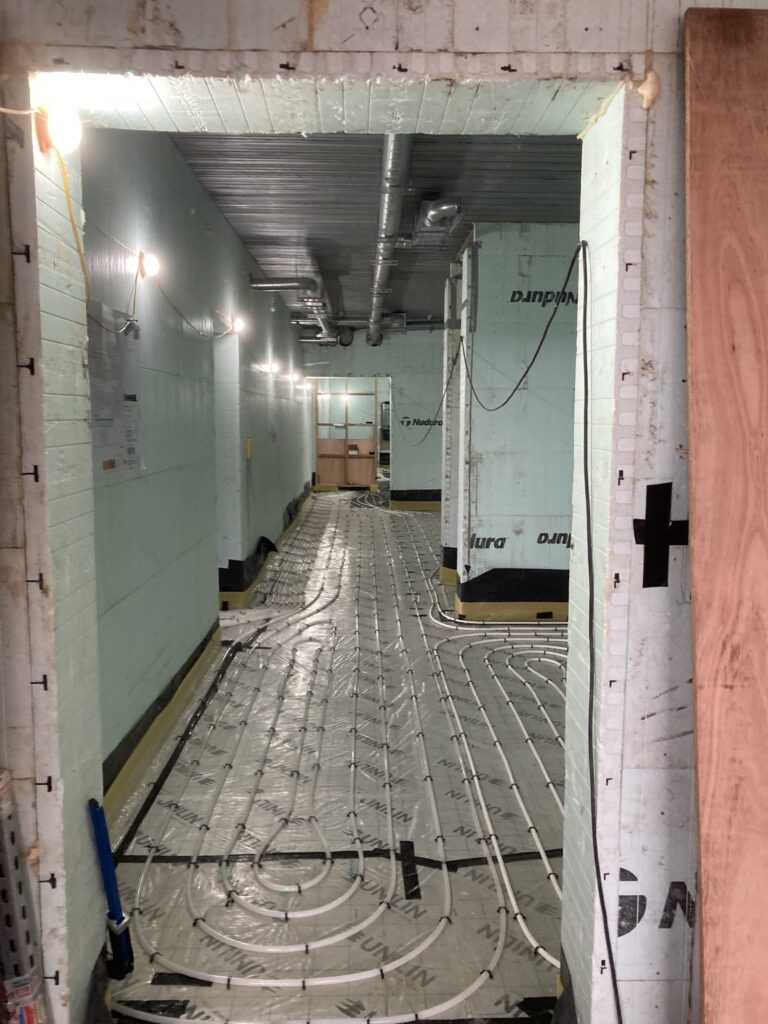

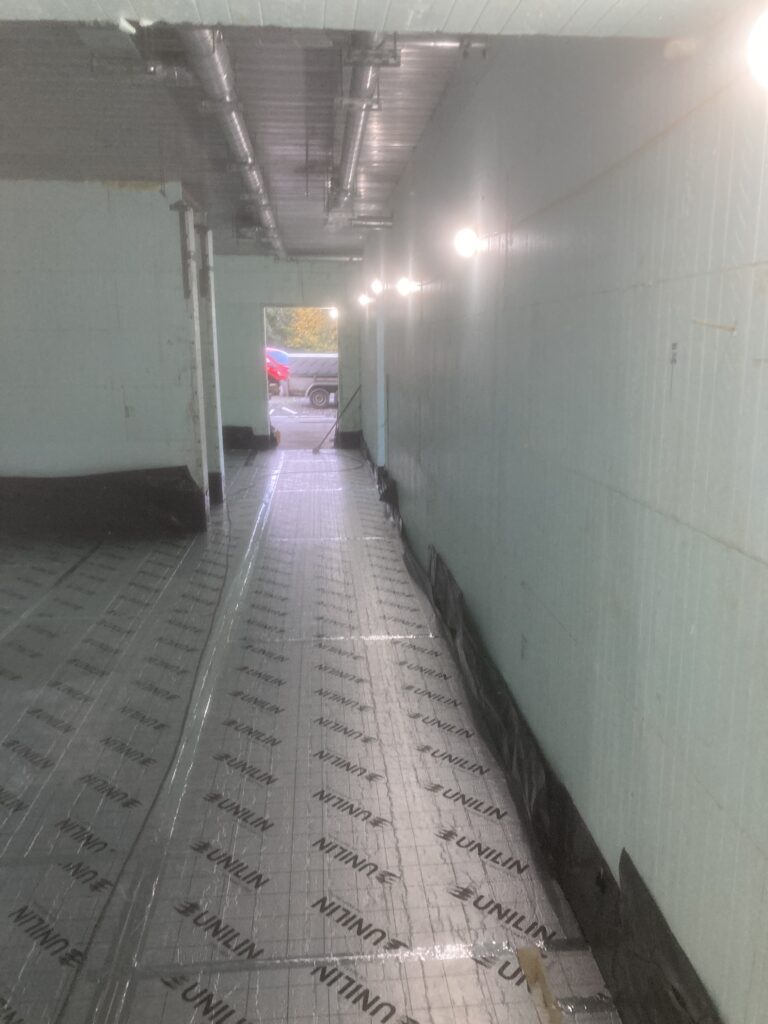

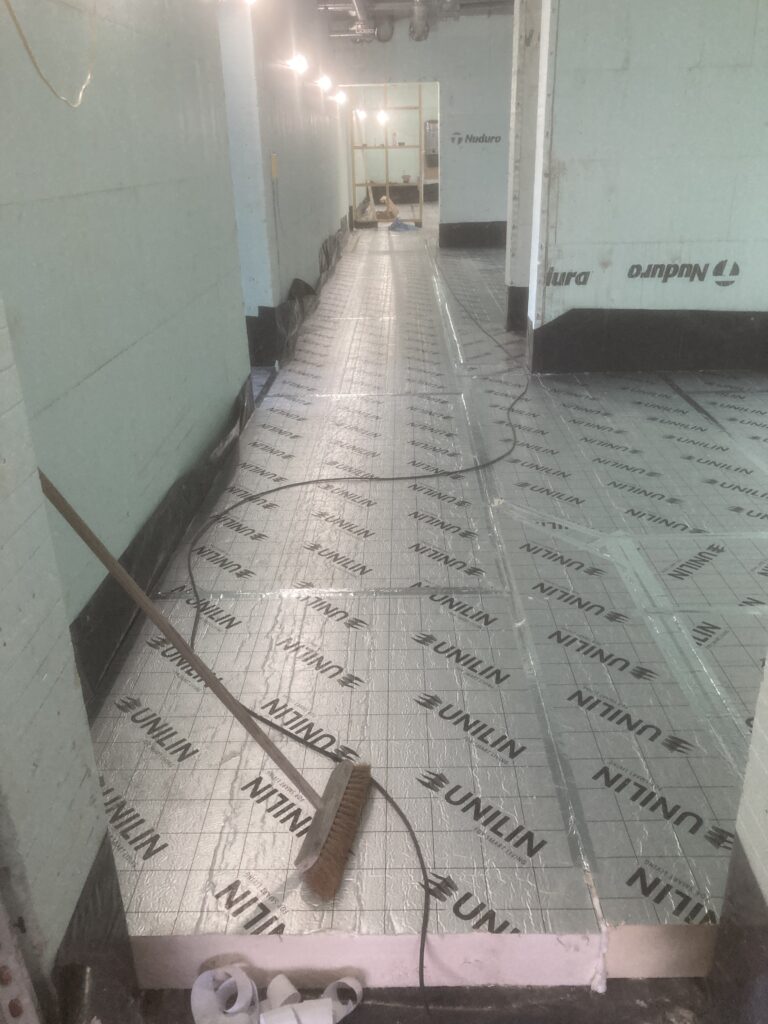

Then the insulation – and foil tape all the joints…

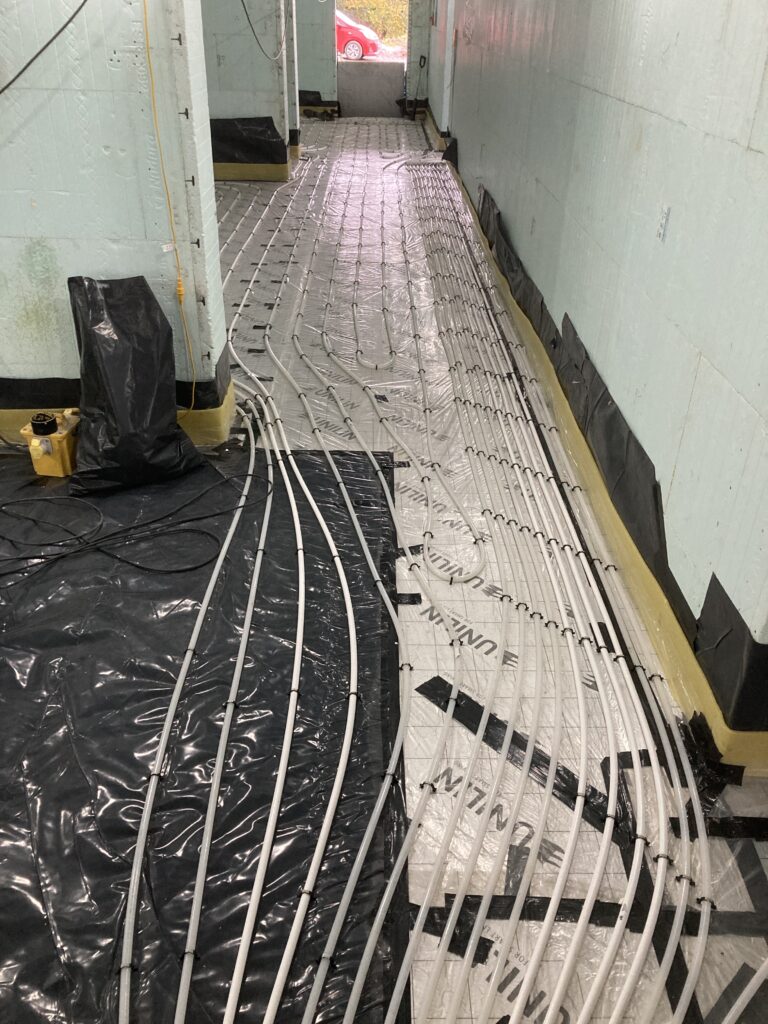

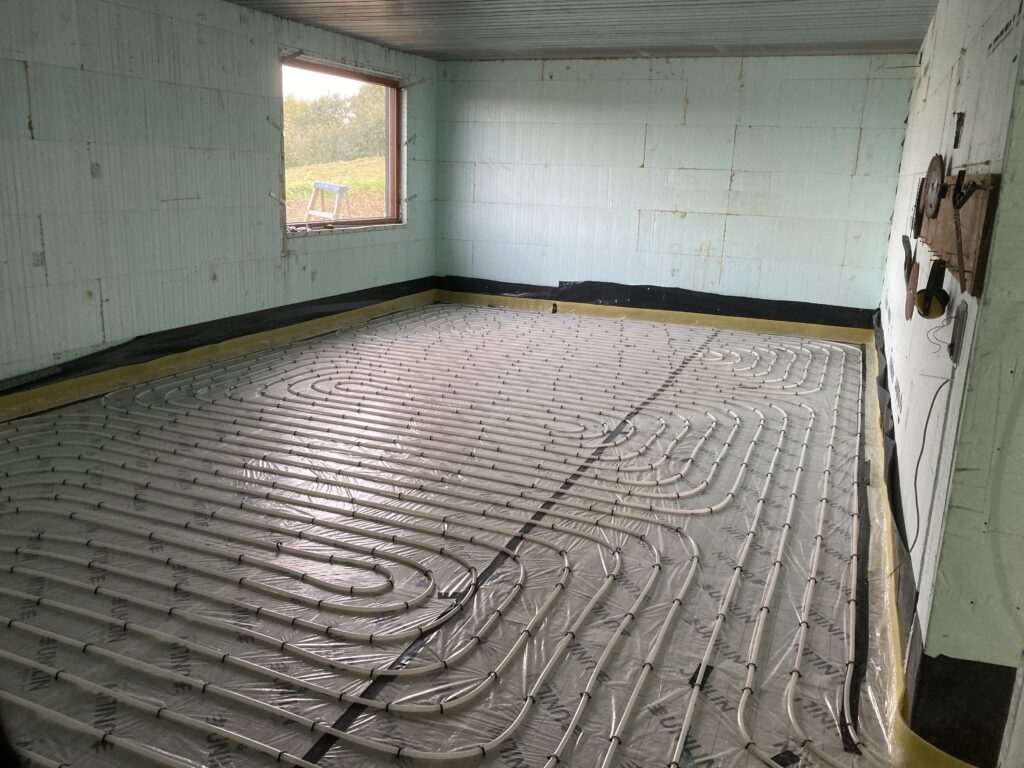

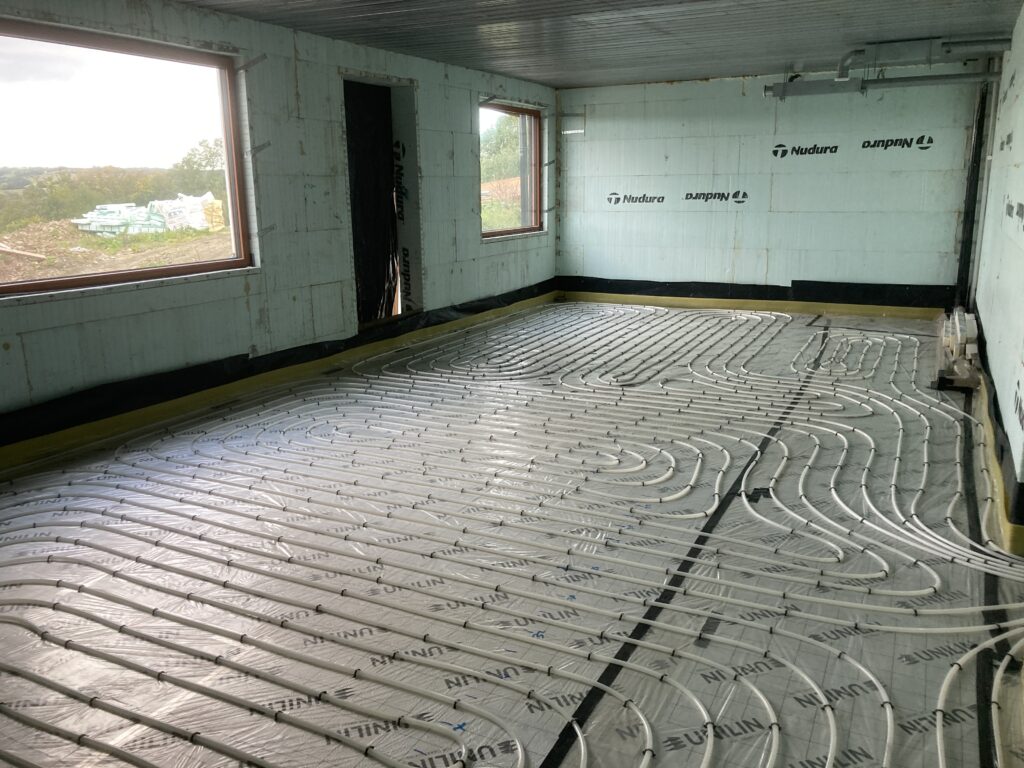

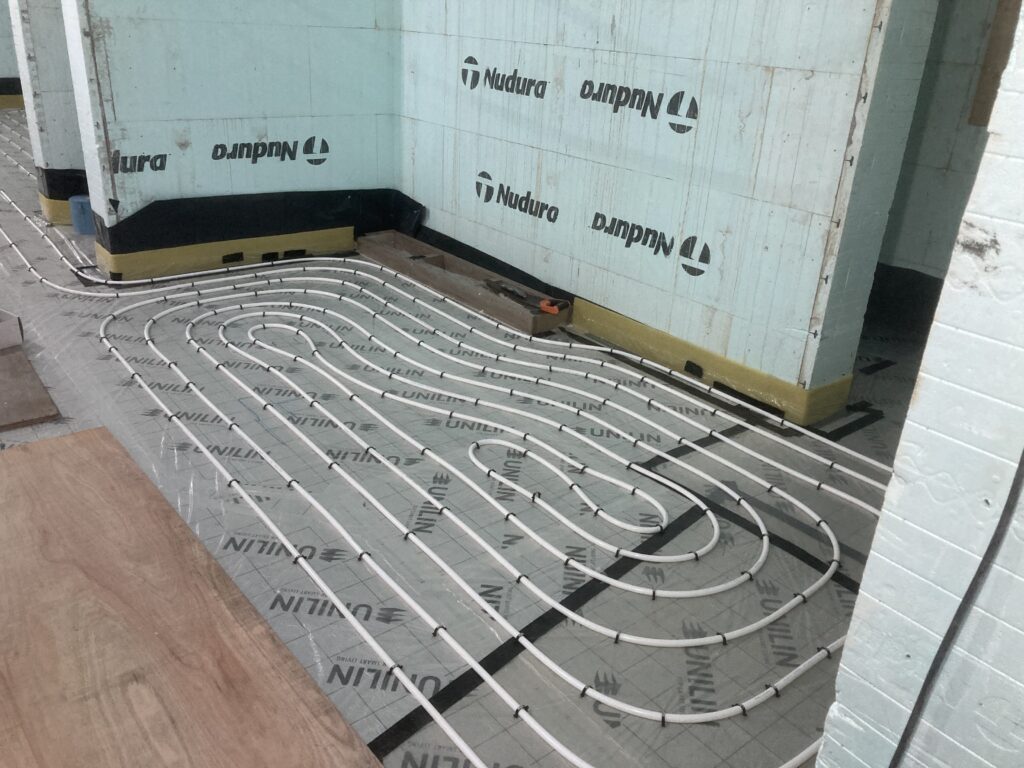

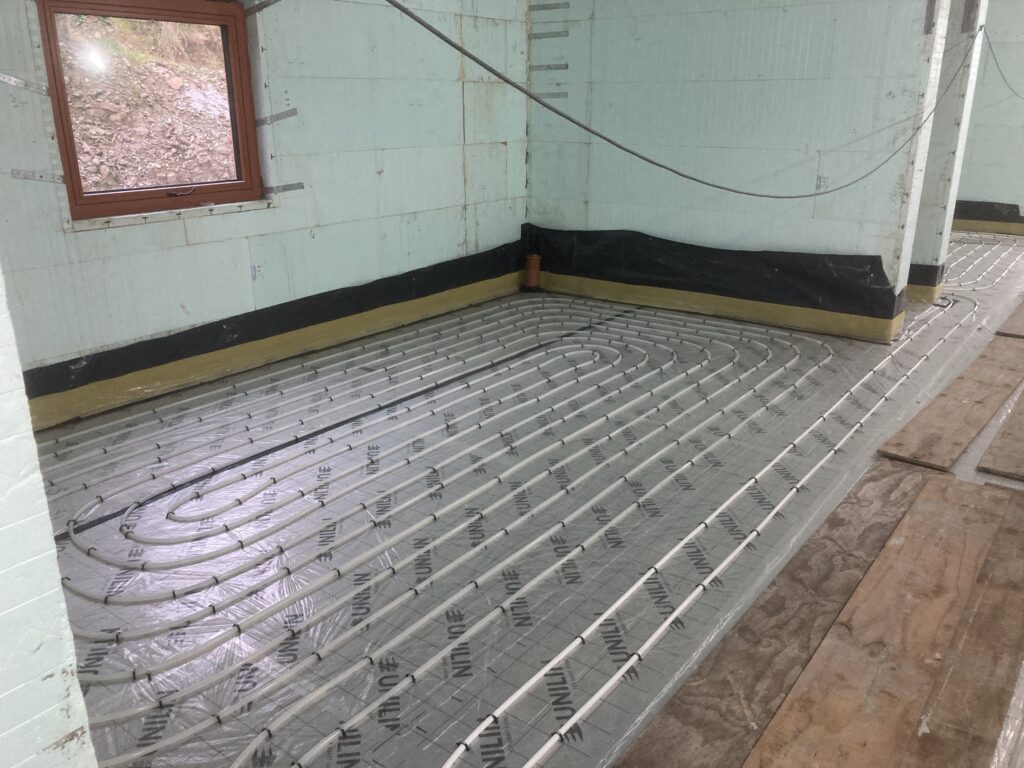

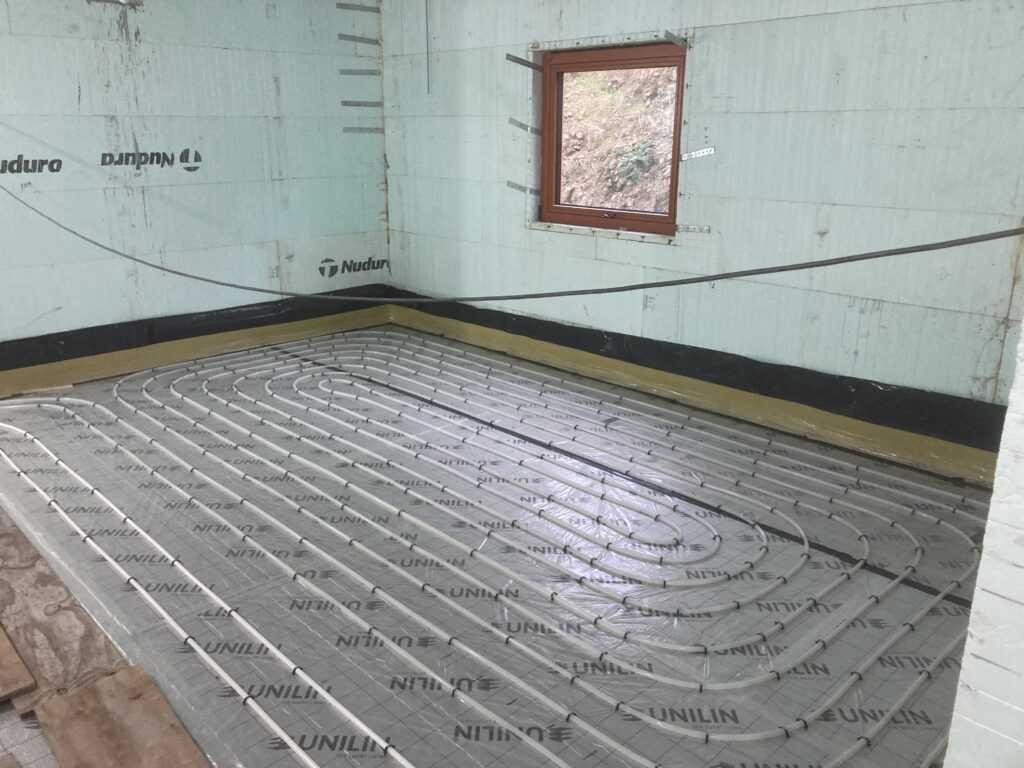

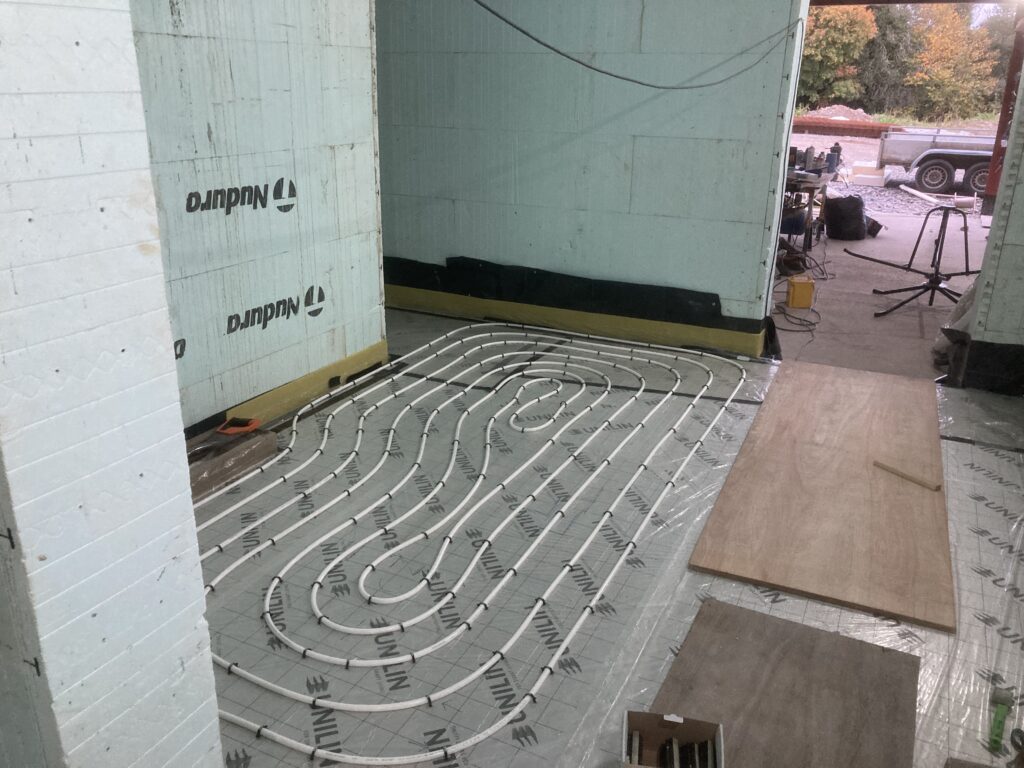

Then the edge foam, insulation and protective membrane before the underfloor heating pipework:

Then the reinforcement mesh

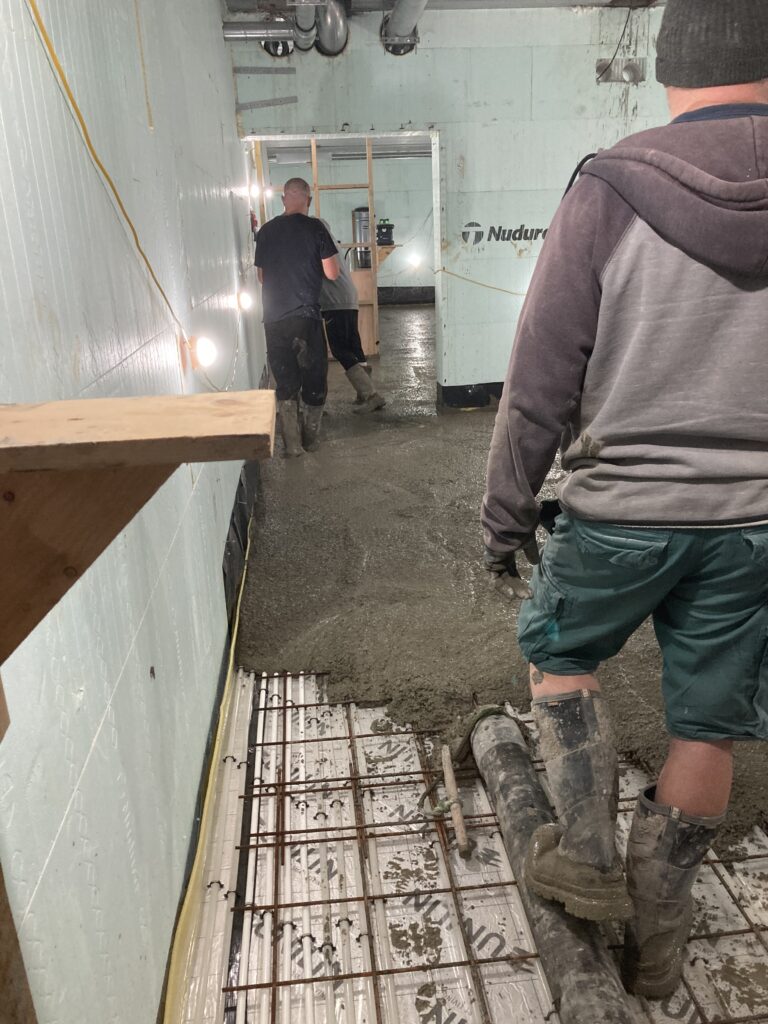

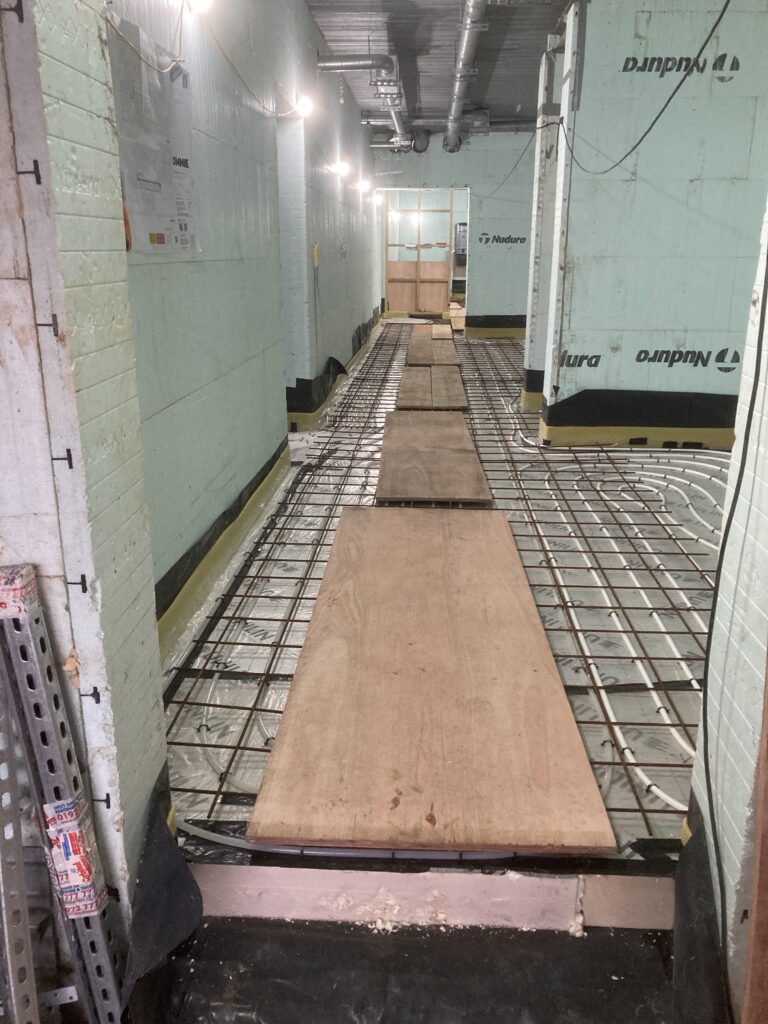

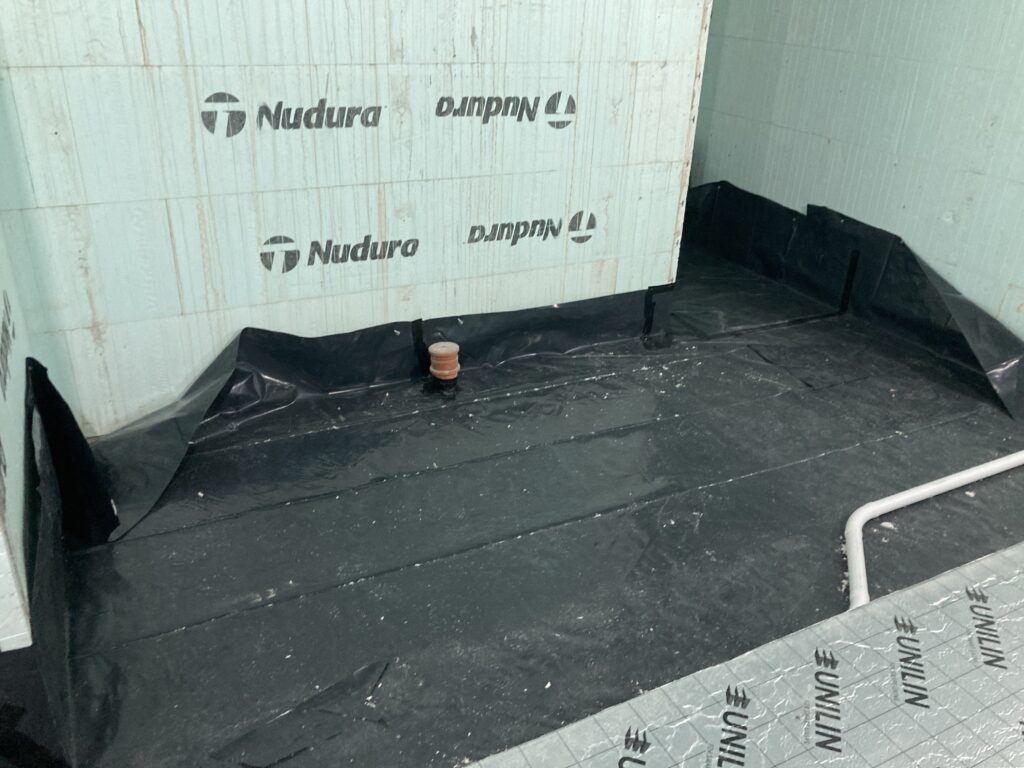

And finally, the door thresholds and the expansion joint between the two pours before the concrete work starts.

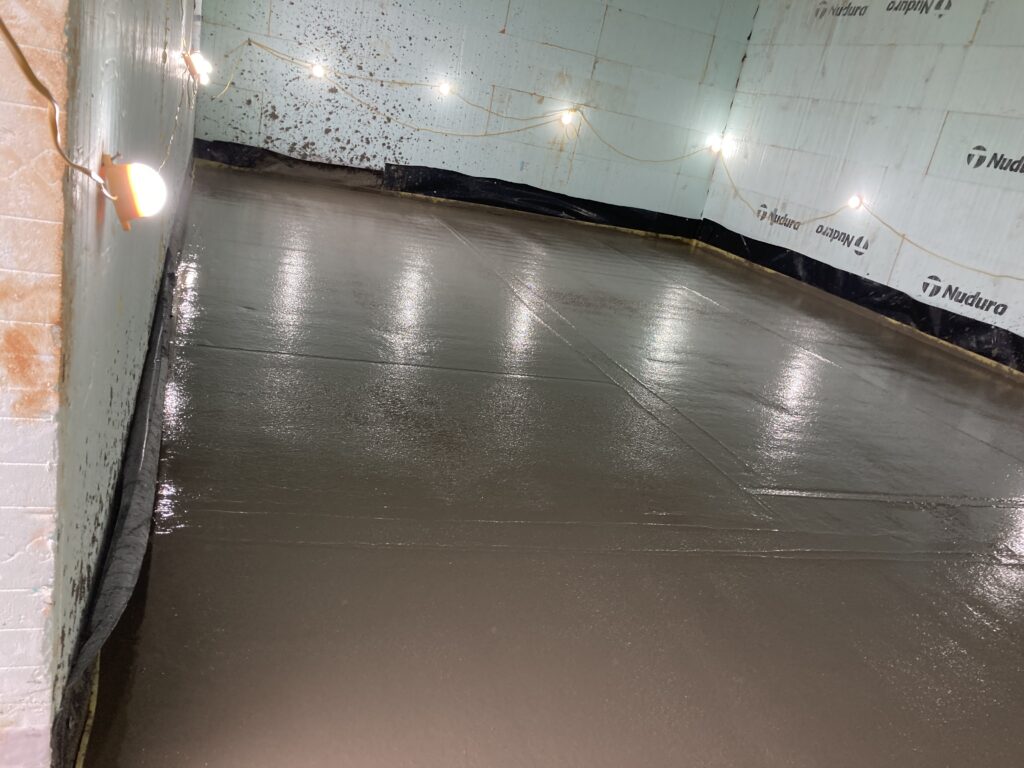

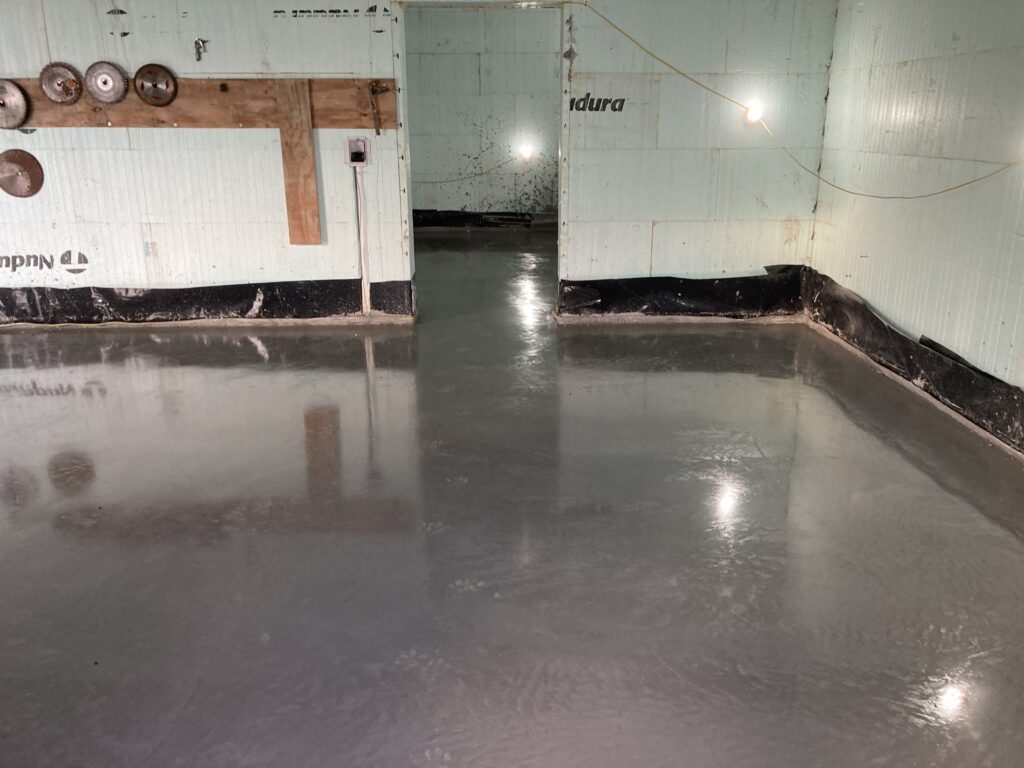

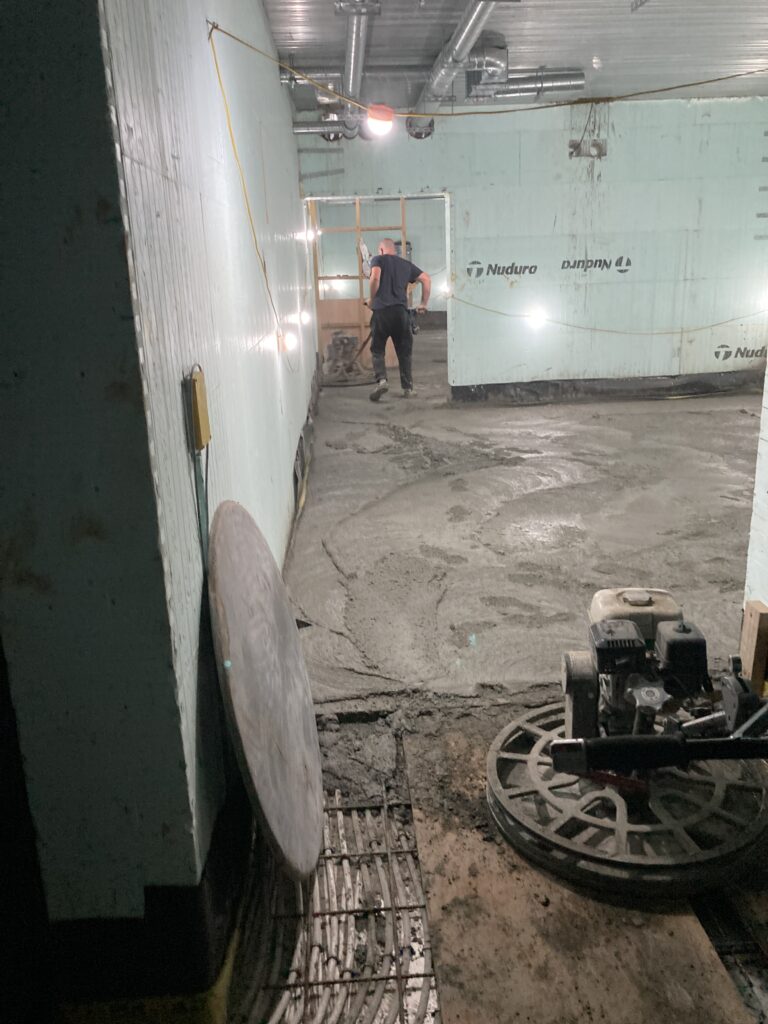

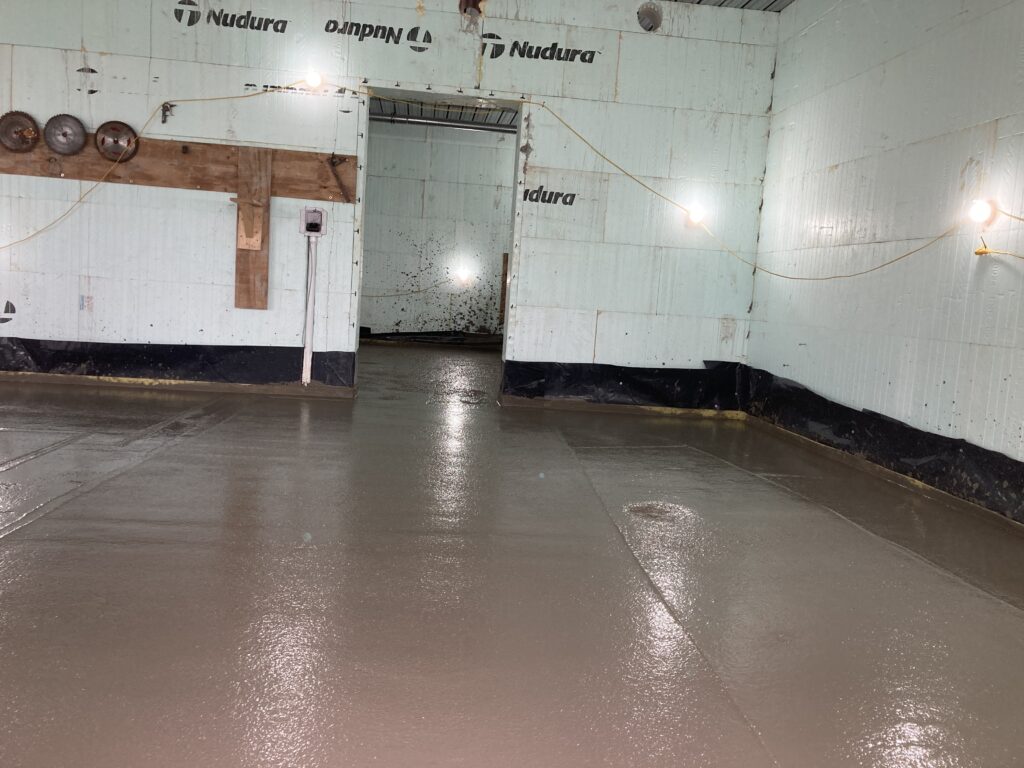

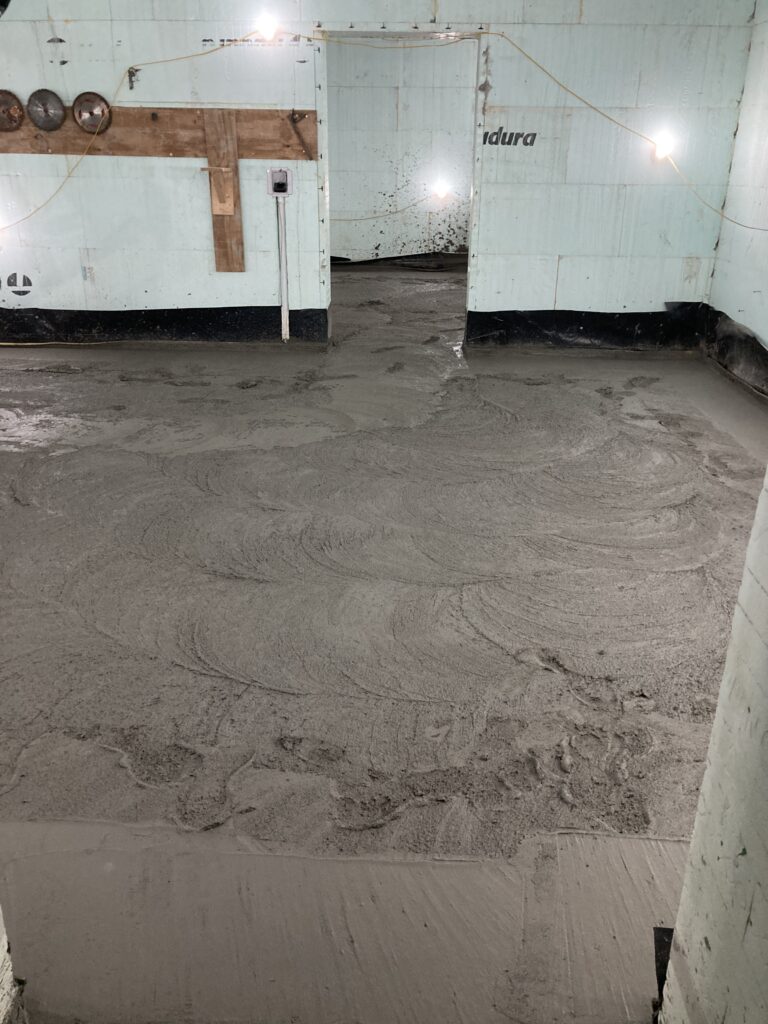

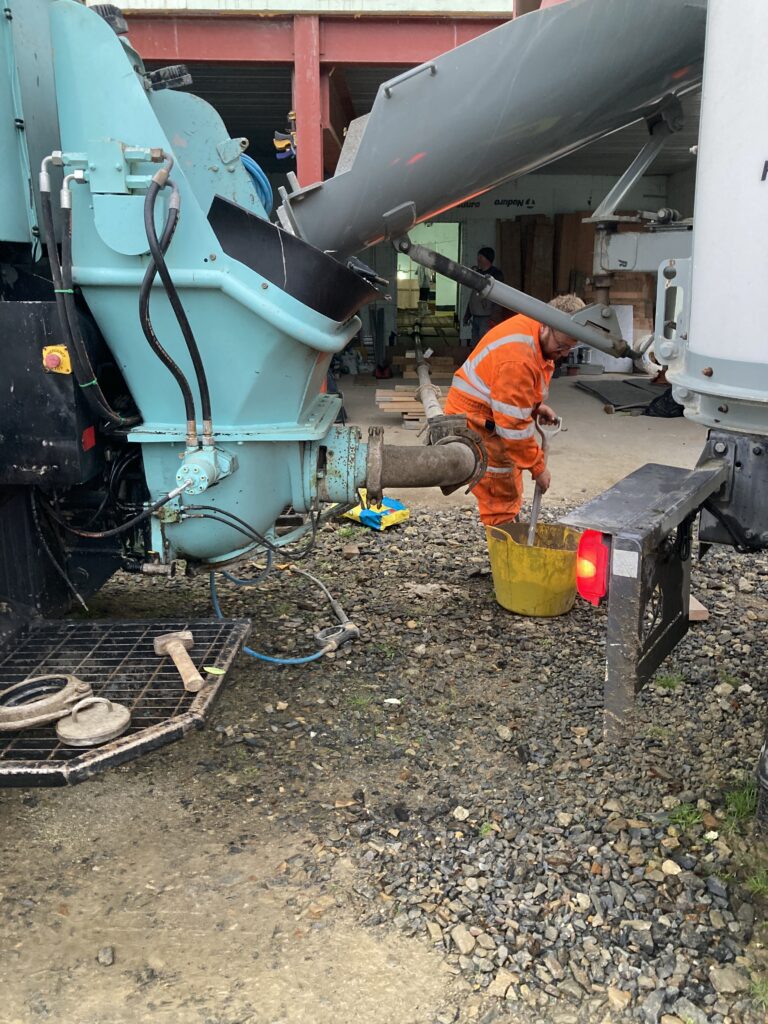

Day one pour:

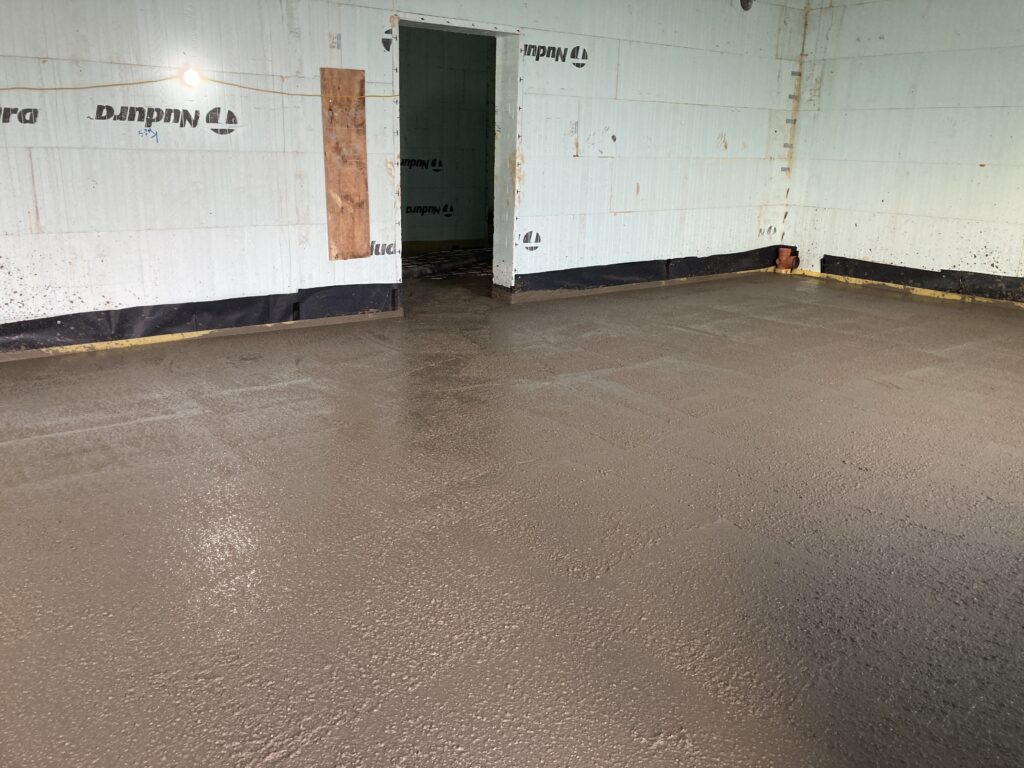

Day 2 pour…

Granny flat concrete in, hallway and lobby next.

And then we started on the stud walls in our bedroom…

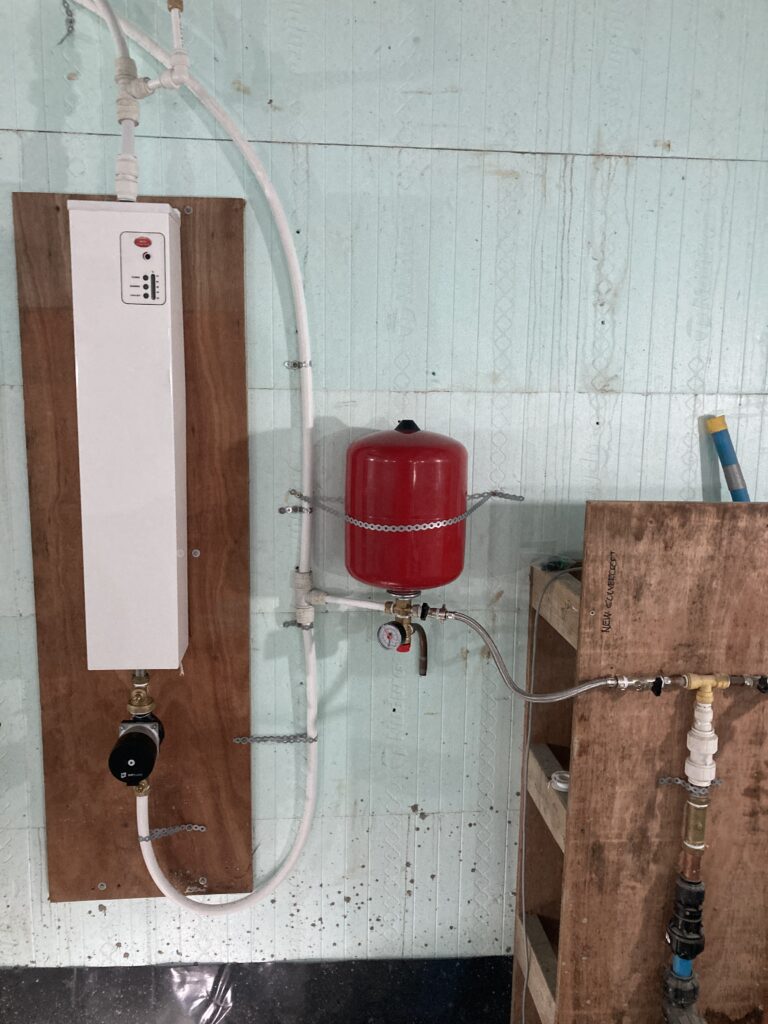

And we installed the temporary heat source for the underfloor heating. Thanks to Adam Cornish at Earth-Inspired for all his advice and help!

Meanwhile, some other interesting pickies from this time last year (and before)…

17th October 2023

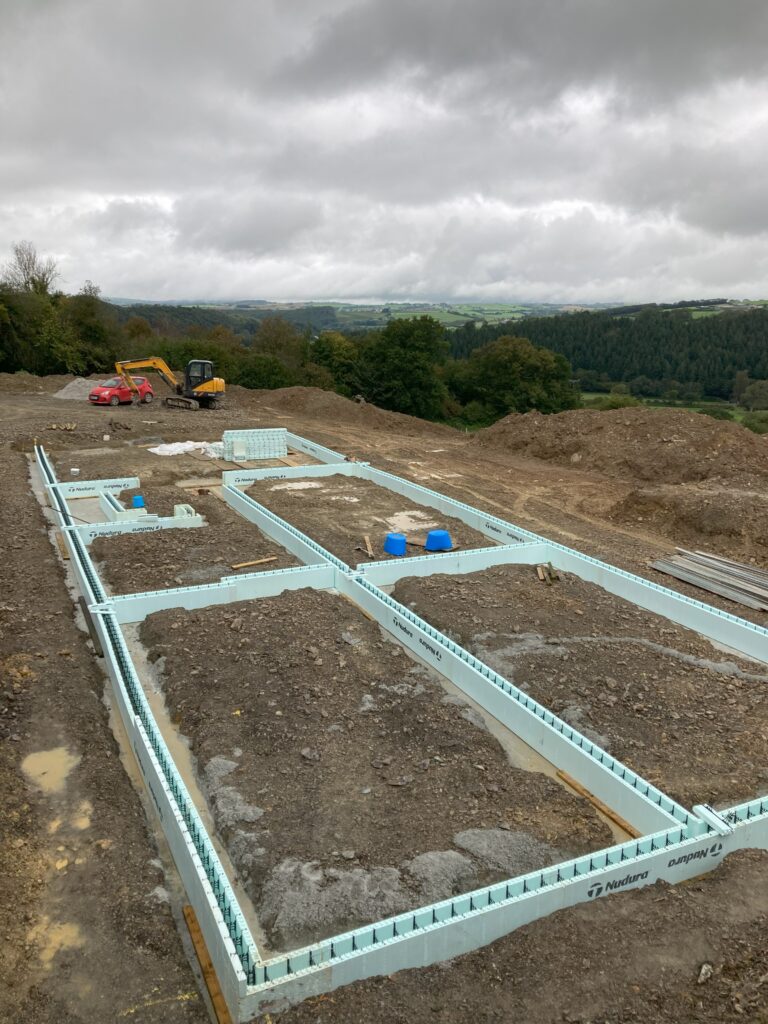

9th October 2023:

An old aerial photo

Next Post

November 2024 - mvhr, studwork, doors, electrics, plumbing...

Sat Nov 2 , 2024
MVHR. Every day’s a school day! We didn’t foresee that by warming up the floors (to dry the concrete) the moisture would condense so much on the rooflights, steel work (cold bridge until insulated) etc. So the focus shifted from studwork to mvhr… Studwork… And we got the doors in downstairs And we met Neil […]
